Summary
Fresh-cut processing facility upgrade cost should be organized by budget category and responsibility rather than by a single machine-price estimate. The buyer needs separate allowances for equipment, conveyors and integration, controls, water and drainage, refrigeration interfaces, civil work, freight, installation, commissioning, training, spares, downtime and food-safety validation. Existing walls, floors, drains, utilities and equipment should be audited before they are treated as reusable. TEEMYEAH can prepare an equipment and budgetary scope from a dimensioned layout, product list, accepted-output requirement and site interfaces; the customer and its contractors retain local civil, utility, regulatory and validation costs unless the commercial proposal states otherwise.
Build the Budget as a Scope Table, Not a Machine List
The following table can be used as the core preliminary budgeting asset.
| Upgrade budget category | Questions the facility must answer | Typical scope to price | Evidence required before budget approval |
|---|---|---|---|
| Existing-asset audit | What can remain without compromising process, capacity or cleanability? | Inspection, condition review, modifications, interfaces | Equipment list, photos, maintenance history, dimensions, utilities |
| Process equipment | Which preparation stages are genuinely required? | Sorting, trimming, peeling, cutting, washing, dewatering, conveying, mixing | Product list, process flow, trials, capacity model |
| Hygienic building work | Can the existing rooms support exposed-product processing? | Floors, walls, ceilings, curbs, partitions, doors, penetrations | Site inspection, room drawings, hygiene-zone plan |
| Drainage | Can water leave the process area without pooling or contaminating adjacent areas? | New drains, channels, slopes, pipework, solids capture | Drain survey, flow estimate, sanitation method |
| Water | Is supply quality, pressure and volume suitable? | Treatment, piping, tanks, pumps, monitoring | Water analysis, consumption model, local requirements |
| Wastewater | What will the wash and sanitation streams contain? | Screening, solids handling, pretreatment, equalization where required | Discharge route, local limits, water balance |
| Electrical | Is sufficient spare capacity available? | Distribution, panels, cabling, isolators, safety circuits | Load schedule, single-line diagram, local code review |
| Controls | How will retained and new machines operate as one system? | PLC integration, sensors, interlocks, recipes, data logging | I/O list, sequence description, control responsibility matrix |
| Compressed air | Which valves or packaging devices require air? | Compressor capacity, dryers, filters, distribution | Equipment consumption schedule |
| Refrigeration | Can the existing cold chain absorb processing and finished-product loads? | Room cooling, cold rooms, evaporators, controls, doors | Heat-load calculation, product flow, operating schedule |
| Packaging | What pack must leave the facility? | Weighing, bagging, sealing, trays, vacuum or other confirmed format | Finished-product specification, pack rate, material specification |
| Traceability | How will transformed lots be identified? | Printers, scanners, software integration, data capture | Lot-flow map, customer and regulatory requirements |

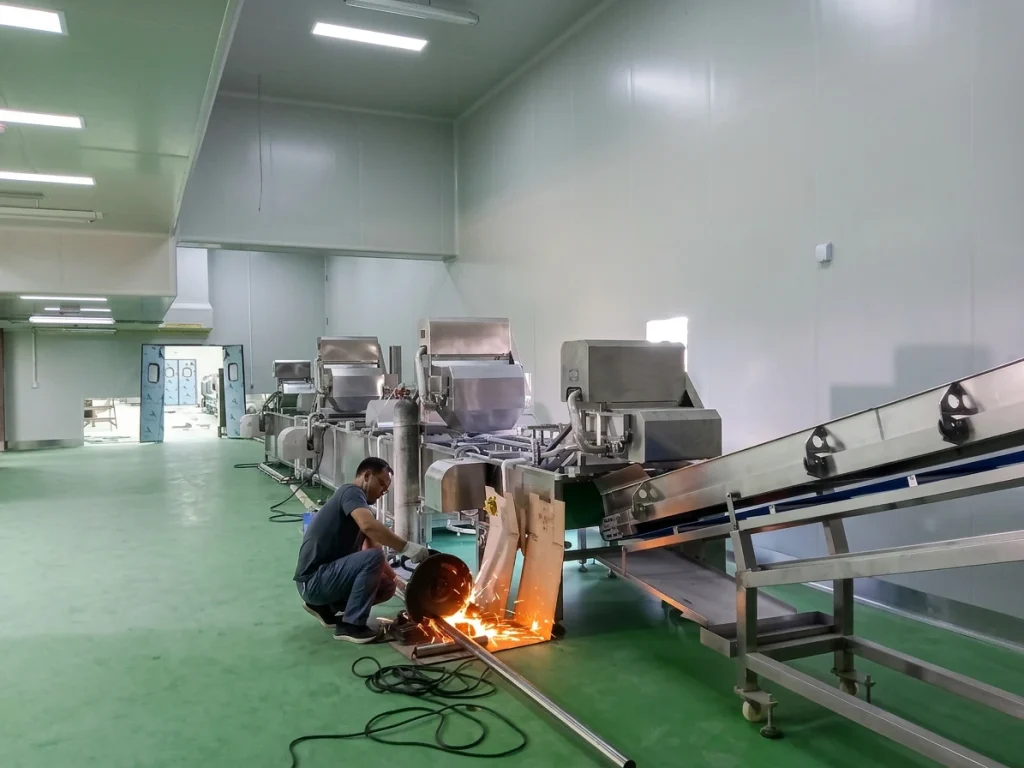

| Installation | Who gets machines into position and connects them? | Rigging, anchors, platforms, piping, cabling, conveyors | Installation drawings, responsibility matrix |
| Commissioning | What must be demonstrated before production release? | Dry testing, wet testing, product trials, tuning | Acceptance protocol, representative raw material |
| Food-safety validation | Which controls require operator validation? | Process studies, wash-water validation where applicable, sanitation verification | Hazard analysis, operating parameters, responsible parties |
| Permits and professional services | Which authorities must approve the modifications? | Building, electrical, plumbing, wastewater, fire, food-related approvals as applicable | Local jurisdiction review |
| Production interruption | Can the current operation stop during construction? | Off-shift work, temporary storage, temporary processing, inventory build | Construction sequence, production forecast |
| Training | Can operators safely run, clean and troubleshoot the new process? | Operator, sanitation and maintenance training | Training matrix, SOP ownership |
| Startup spares | What failure would stop production? | Blades, belts, seals, sensors, baskets and other agreed critical parts | Critical-spares review |
| Working capital | What cash is needed beyond installed assets? | Packaging, labels, chemicals, trial material, inventories and receivables | Startup volume forecast and purchasing terms |
| Contingency | Which assumptions remain unresolved? | Allowance against documented uncertainty | Open-issue register rather than an arbitrary percentage |
The table should eventually be converted into a responsibility matrix showing what is included in the equipment supplier’s quotation, what is supplied locally, and what remains the owner’s responsibility.
Without that separation, two quotations that appear to compete on price may cover substantially different projects.
Ready-to-Eat and Ready-to-Cook Upgrades Should Not Be Budgeted as Identical Projects
Ready-to-cook vegetables may eventually receive a cooking or other downstream treatment. Ready-to-eat fresh-cut products, by definition, may be consumed without such a later step.
That distinction does not make ready-to-cook production exempt from sanitation or food-safety controls. It does mean that the risk analysis and post-process exposure conditions are different.
For an RTE project, the existing building should be examined particularly closely for:
- movement from raw to post-wash product;
- dirty and cleaner process routes;
- shared personnel or equipment movement;
- cleaning-tool segregation;
- exposed-product handling;
- drainage interactions;
- condensate;
- sanitation access;
- packaging-room conditions;
- cold-chain continuity;
- environmental monitoring where required by the facility’s hazard analysis and regulatory framework.
FDA guidance for RTE fresh-cut produce specifically discusses plant construction, sanitary operations, potable process water, plumbing and drainage, food-contact equipment, sanitation controls and time-temperature management. It also notes the concern created when exposed RTE food has no subsequent treatment that would significantly minimize relevant biological hazards.
The practical budget implication is straightforward: do not price the RTE processing equipment before checking whether the room around it can support the RTE process.
Floors, Drains, Walls and Hygienic Separation Can Decide Whether a Retrofit Is Economical
Existing produce buildings often contain wet areas, but a wet area is not automatically a hygienically designed fresh-cut room.
Continuous vegetable washing may generate:
- product fragments;
- soil and grit;
- organic matter;
- spray;
- wash water;
- equipment-cleaning water;
- sanitation solutions;
- mobile bins and waste traffic.
Drainage must handle the actual production and cleaning scenario.
FDA fresh-cut guidance discusses sloping floors toward drains, preventing water accumulation around floor drains, maintaining drain accessibility for cleaning and considering separation between packhouse flumes and fresh-cut operations where practical.
For budgeting purposes, inspect the complete path of water:
machine discharge → floor or dedicated pipe → drain/channel → solids separation → plant wastewater system → permitted discharge route
Do not stop the investigation at “there is a drain beside the machine.”
Walls, ceilings and overhead services deserve similar attention. Existing construction may need modification where surfaces cannot be effectively cleaned, where water penetrates joints, or where overhead condensation could affect exposed product or food-contact surfaces.
A retrofit becomes expensive when these issues are discovered after the processing equipment has already been ordered.
Water and Wastewater Should Be Sized Together
Fresh-cut processing converts water from a minor building utility into a production input.
A water balance should account for:
- product washing;
- tank filling;
- continuous makeup;
- overflow;
- rinsing;
- equipment cleaning;
- floor cleaning;
- sanitizer preparation where applicable;
- handwashing and hygienic facilities;
- other concurrent production.
The wastewater model should correspond to the water model.
Estimate not merely liters or gallons, but what is carried in the discharge:
- vegetable particles;
- soil;
- suspended solids;
- dissolved organic material;
- cleaning chemicals;
- sanitizer residuals where applicable;
- variable pH or other parameters relevant to the local discharge authority.
In the United States, EPA’s pretreatment framework applies to nondomestic wastewater discharged to publicly owned treatment works, while individual utilities can impose site-specific local limits. A facility cannot therefore assume that an existing sewer connection gives unlimited permission to discharge a new food-processing wastewater stream.
The same principle applies internationally: confirm the actual receiving system and discharge requirements before finalizing water-intensive equipment.
Possible retrofit scope may include screens, solids collection, additional drains, tanks, pumps, separation equipment or other local pretreatment measures. The correct configuration depends on the waste stream and local requirements rather than a generic fresh-cut specification.
Electrical and Controls Scope Extends Beyond Motor Kilowatts
The electrical budget is frequently underestimated because buyers add the connected power of the new machines and stop there.
A retrofit review should also consider:
- available panel capacity;
- distribution distance;
- cable routing;
- wet-area electrical requirements;
- isolators and disconnects;
- safety devices;
- emergency stops;
- machine interlocks;
- variable-frequency drives where used;
- sensors;
- instrumentation;
- network connections;
- control cabinets;
- integration with retained machines.
A new line also changes occupational risk.
Vegetable cutters introduce cutting and rotating components. Conveyors introduce nip and entanglement points. Centrifugal dewatering equipment introduces rotating energy. Automated transfer can start equipment remotely or as part of a sequence.
OSHA’s machine-guarding materials emphasize protection from points of operation, rotating parts and other moving-machine hazards. Its hazardous-energy standard addresses servicing and maintenance where unexpected startup or release of stored energy could injure personnel.
That means the retrofit budget should include not only production controls but also the access, guarding, isolation and training required to operate and maintain the final connected system.
Automation can remove some repetitive manual handling while simultaneously creating new maintenance and machine-safety requirements.
Refrigeration Should Be Recalculated After the Process Is Defined
A produce distribution facility may already be refrigerated, yet its existing system was sized around its current operating model.
Fresh-cut production can change:
- where people work;
- how long product remains exposed;
- door-opening patterns;
- equipment heat loads;
- work-in-process inventory;
- finished-product inventory;
- packing-room demand;
- dispatch staging;
- sanitation schedules.
FDA’s fresh-cut guidance discusses time-temperature controls because cut produce can support microbial growth differently from intact produce and because processing and finished-product holding may require refrigerated conditions depending on the product and hazard analysis.
The refrigeration engineer therefore needs a new heat-load calculation, not an assumption that the current cold room has enough spare capacity because some pallet positions appear empty.
The calculation may need to account for product load, people, lights, motors, door infiltration, room construction, defrost operation and surrounding conditions.
A project might reuse the existing raw-material cold room but require a new finished-product room. Another might retain the refrigeration plant but need different evaporators, doors or processing-room cooling. A third may have enough installed cooling capacity but lack the airflow or room configuration required by the new process.
These scenarios have very different budget consequences.
Commissioning and Validation Are Different Activities
A machine can operate mechanically and still fail to produce the required finished product.
Commissioning typically establishes that the equipment has been installed, connected and set up to operate according to the agreed project scope.
Product and process verification asks a different set of questions:
- Does the cutter achieve the required geometry?
- Does the product feed consistently?
- What practical throughput is achieved?
- Where does WIP accumulate?
- Does washing perform as intended under representative product load?
- Is the moisture condition suitable for packing?
- How does the process behave with seasonal raw-material variation?
- How long does changeover take?
- Can sanitation crews access the required areas?
- Can the intended sequence restart after a stoppage?
Food-safety validation remains the responsibility of the food operator and relevant qualified specialists.
Where an antimicrobial substance is used as a process control in fresh-cut wash water, for example, FDA guidance discusses validation in relation to the commodity, antimicrobial concentration, organic load, monitoring and other process parameters. Purchasing a dosing pump or washing tank does not by itself validate the control.
This distinction should be reflected in both the project schedule and the budget.
Labor Should Be Modeled From Actual Work, Not From a Headcount Reduction Promise
Labor dependency is a legitimate reason for a produce business to investigate automation, especially where preparation involves repetitive washing, trimming, cutting, basket handling or manual transfers.
But a project should not be justified using an unsupported statement such as “this machine saves five workers.”
Measure the current operation instead.
Useful indicators include:
Labor hours per 1,000 kg
Labor hours per 1,000 kg = Direct preparation labor hours × 1,000 / Accepted finished kg
Use accepted finished output rather than incoming raw weight if the objective is to compare the labor required to produce saleable product.
Yield
Yield % = Accepted finished kg / Raw input kg × 100
Yield should be defined consistently. If the plant changes how it classifies trimming waste or retained wash water, the comparison becomes misleading.
Practical throughput
Practical throughput = Accepted finished kg / Production clock hours
The denominator should be defined consistently. A buyer may calculate both gross shift throughput and net running throughput, but should not compare one against the other.
Preparation cost per kilogram
Preparation cost/kg = Relevant preparation operating cost / Accepted finished kg
Possible components include:
- direct labor;
- sanitation labor;
- water;
- electricity;
- sanitation consumables;
- maintenance;
- waste handling;
- packaging-related operating cost where relevant.
Sanitation time ratio
Sanitation time ratio = Sanitation hours / Scheduled operating hours × 100
A more automated line can reduce some manual production work while increasing the quantity of equipment requiring cleaning. That trade-off must be measured.
Downtime rate
Downtime rate = Unplanned stopped time / Planned production time × 100
Automation concentrates risk when several processing stages depend on one machine or control system.
U.S. Bureau of Labor Statistics data show that food-processing equipment work remains a substantial occupational category and that replacement hiring contributes materially to projected openings. That national labor-market context can explain why processors are interested in reducing labor dependency, but it should not be inserted directly into a single facility’s ROI calculation.
The facility should instead use its actual wages, benefits, overtime, recruitment cost, absence, turnover, training time and agency-labor exposure.
Scope Exclusions Should Be Written as Carefully as Scope Inclusions
A preliminary upgrade budget should contain an exclusions section.
Typical questions include:
- Is civil work included?
- Are new drains included?
- Is electrical cabling included?
- Is the main distribution-board modification included?
- Is refrigeration included?
- Are cold rooms included?
- Is wastewater treatment included?
- Is packaging equipment included?
- Is product testing included?
- Are antimicrobial dosing systems included?
- Are local permits included?
- Is installation labor included?
- Are technician travel costs included?
- Are operator and maintenance training included?
- Are startup spare parts included?
- Are third-party validation services included?
- Are local taxes and duties included?
- Is temporary production included?
The point is not that every supplier should provide every item.
The point is that the owner should know who is providing it.
An equipment quotation and a facility-upgrade budget are different documents.
What a Supplier Should Confirm Before Issuing a Serious Retrofit Proposal
A project-stage supplier discussion should move beyond general catalog questions.
The supplier should request enough information to understand:
- raw materials;
- incoming condition;
- finished product;
- RTE or RTC classification;
- required cuts;
- hourly and daily saleable output;
- number of SKUs;
- batch sizes;
- seasonal variation;
- operating hours;
- sanitation schedule;
- existing equipment;
- available footprint;
- floor plan;
- working heights;
- water conditions;
- drains;
- power specification;
- cold-room interfaces;
- packaging format;
- preferred automation level;
- target project schedule.
Representative raw-material testing becomes especially useful where product sensitivity is uncertain.
A leafy vegetable can behave differently from a firm root vegetable during cutting, washing and centrifugal dewatering. Two varieties of the same crop can also behave differently.
Equipment selection should therefore follow the process requirement rather than forcing every raw material through whichever machine has the largest catalogue capacity.
Copyable Upgrade Budget Categories
| Budget category | Typical TEEMYEAH proposal input | Buyer or third-party input |
|---|---|---|
| Equipment and process modules | Specified machines, options and product-conditioned capacity basis | Product, output and acceptance requirements |
| Conveyors, controls and integration | Mechanical transfers, local controls and defined signal interfaces | Existing equipment data and plant control standards |
| Water, drainage and utilities | Equipment connection requirements and discharge points | Supply systems, floor drains, treatment and civil work |
| Cold and packing interfaces | Product handoff condition, height, speed and signals | Refrigeration, packer, traceability and room conditions |
| Freight, installation and commissioning | Packing, shipment, supplier travel and agreed technical work | Customs, lifting, local labor, tools, permits and utilities |
| Training, spares and documents | Agreed manuals, drawings, training and spare-parts list | Attendance, local language and maintenance ownership |
| Validation and site approval | Equipment records and test support stated in the proposal | Food-safety validation, regulatory approvals and third-party certification |
Frequently Asked Project Questions
Which inputs change the equipment budget most?
Product condition, accepted-output capacity, number of stages, redundancy, dewatering method, cleaning access, control integration and packing handoff can all change the equipment scope.
Which costs are normally outside an equipment quotation?
Unless expressly included, the buyer should expect local civil work, building services, utilities, drains, refrigeration, permits, customs, lifting, local labor and validation costs.
How should two supplier budgets be compared?
Place each proposal into the same category table and record included, excluded, provisional and buyer-supplied items. Compare the scope before comparing totals.
When should the project use a budgetary scope instead of a final quotation?
Use a budgetary scope while the layout, product trial, utility data or third-party work can still change the configuration.
Can a retrofit avoid production downtime?
Sometimes work can be staged, but shutdown, cleaning, removal, installation, testing and ramp-up should be planned explicitly rather than assumed away.
